01The hall to true scale
Cabinets, rows and aisles at their real dimensions. The floor plan is the model, not a picture of one.
GPU cluster deployment.
Photographs of completed GPU and structured-cabling programs — and the scope, routes, timelines and certification records behind them — go out on request, under NDA, rather than onto a public page.
Tell us what you are building and we will send the programs that match it, at whatever level of detail your procurement needs.
Request photos & project details→The work is North American. The record is worldwide.
01Cabinets, rows and aisles at their real dimensions. The floor plan is the model, not a picture of one.

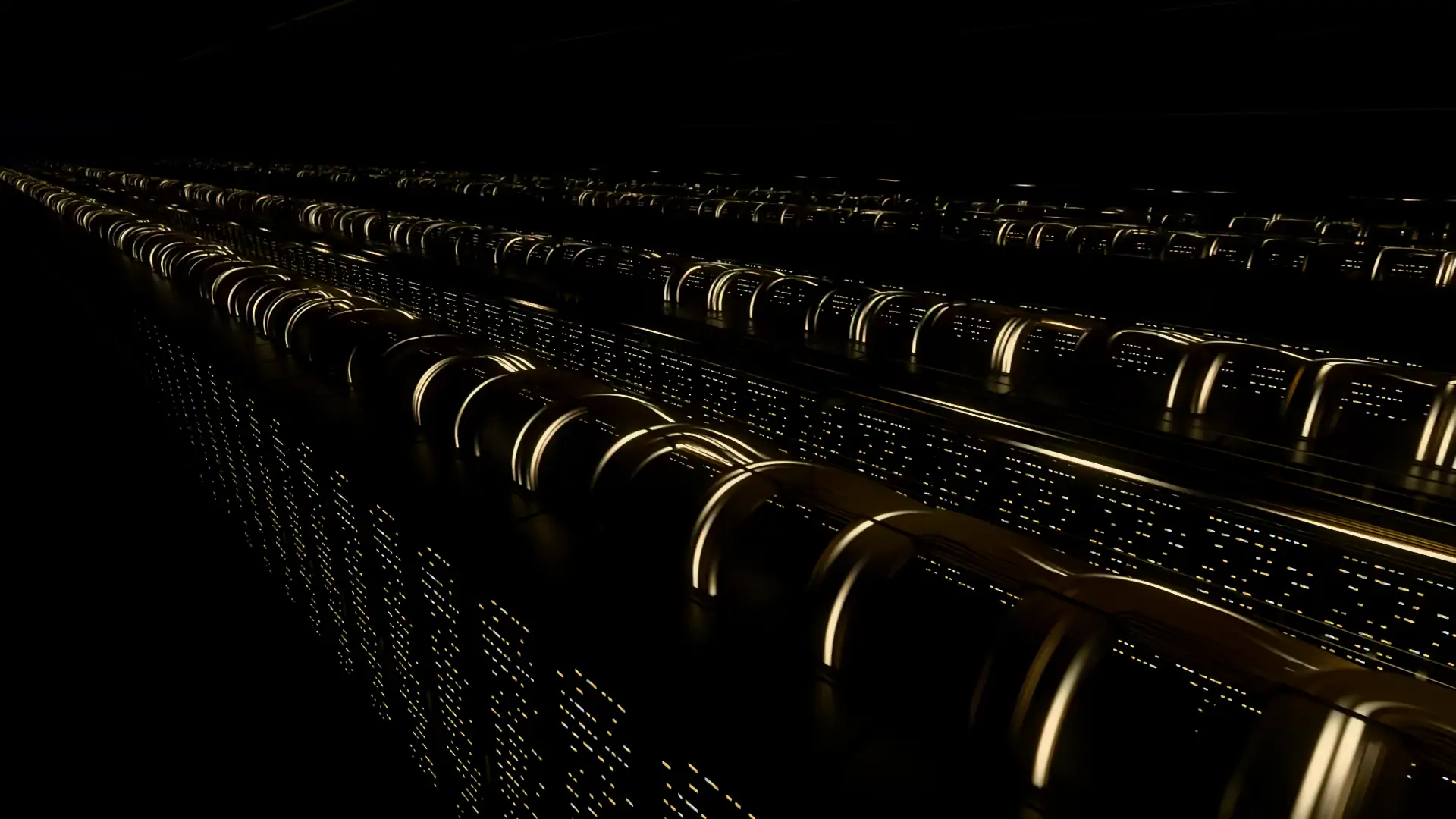

02Overhead runs drawn where they will be hung, with the cable count carried on every span.
03Every span knows what it carries and how far it goes — the cut list comes off the drawing, not a tape measure.
04Install, power fit, fiber pull, test, label, sign-off. Each cabinet carries its own checklist and its own history.
05Build-out per hall, approvals waiting on a signature, and what changed on the floor in the last hour.
06The as-built is generated out of the model — not compiled from photographs after the crew has gone.
The same hall in three dimensions.
Pathways and trays go in around the racks; cooling and power follow once they stand. Every step ends with a record you keep.
We work out every route and measurement for tray and cable, then price the job from your design plans before you sign.
Takeoff · rev. CPre-contract
Racks48
Tray, ft1,240
Busway, ft460
Cooling hose, ft960
Trunks312
Quote readyWe set the pathways before the racks arrive, then hang and bond the cable trays above the rows once the frames stand.
Trays & pathways · rows A–EBonded
Tray runs complete12 / 12
Tray hung, ft1,240
Bond, TGB → tray0.04 Ω
We check every delivery against the bill of materials and stage it according to the pull schedule. In our app the hall becomes an interactive map, so you can follow any cable's path from the dock to its port.
Hall · rows A–EInteractive map
TRK-C07 → R-C07312 / 312 checked
We mark each rack's spot on the floor and level each frame on its mark before servers go in. Fixing a frame later means pulling everything back out.
Rack R-C07Position marked
Frame level0.4 mm/m
Switch U42 · screws torqued2 / 2
We connect each rack to the cleaned cooling loop, remove trapped air and check every joint for leaks. That happens with the rack still open, before any cable or power goes in.
Loop connect · rack R-C07Before power
Purged · 30 min hold, no leaksPass
Busway hangs over the rows, each rack gets its tap-off, and every run is tested before it goes live.
Busway BW-C · feed ATap-off R-C07
Insulation 2.1 GΩ · torquedLive
We cut every cable to a length planned from the port map. Then we comb, strap and support each run at its rated bend radius.
Rack R-C07 · frontDressed
Strapped · bend radius held30 mm
We log each connection on the port map as we patch it, so the records match the finished hall.
Patch panel PP-C07 · 12PMap updated live
TRK-C07 → B0712 / 12 linked
We test every copper link and every fiber in each trunk. The results go to you exactly as the instrument recorded them.
Link #041 · Cat6ACertification
Length43.8 m
Wire map8 / 8
NEXT margin+8.4 dB
Rated for10G
PassWe close out each row as it's completed. Your handover pack is built from the live record while the crew is still on site.
Handover packBuilt from the live record
Row ARow BRow CRow DRow E

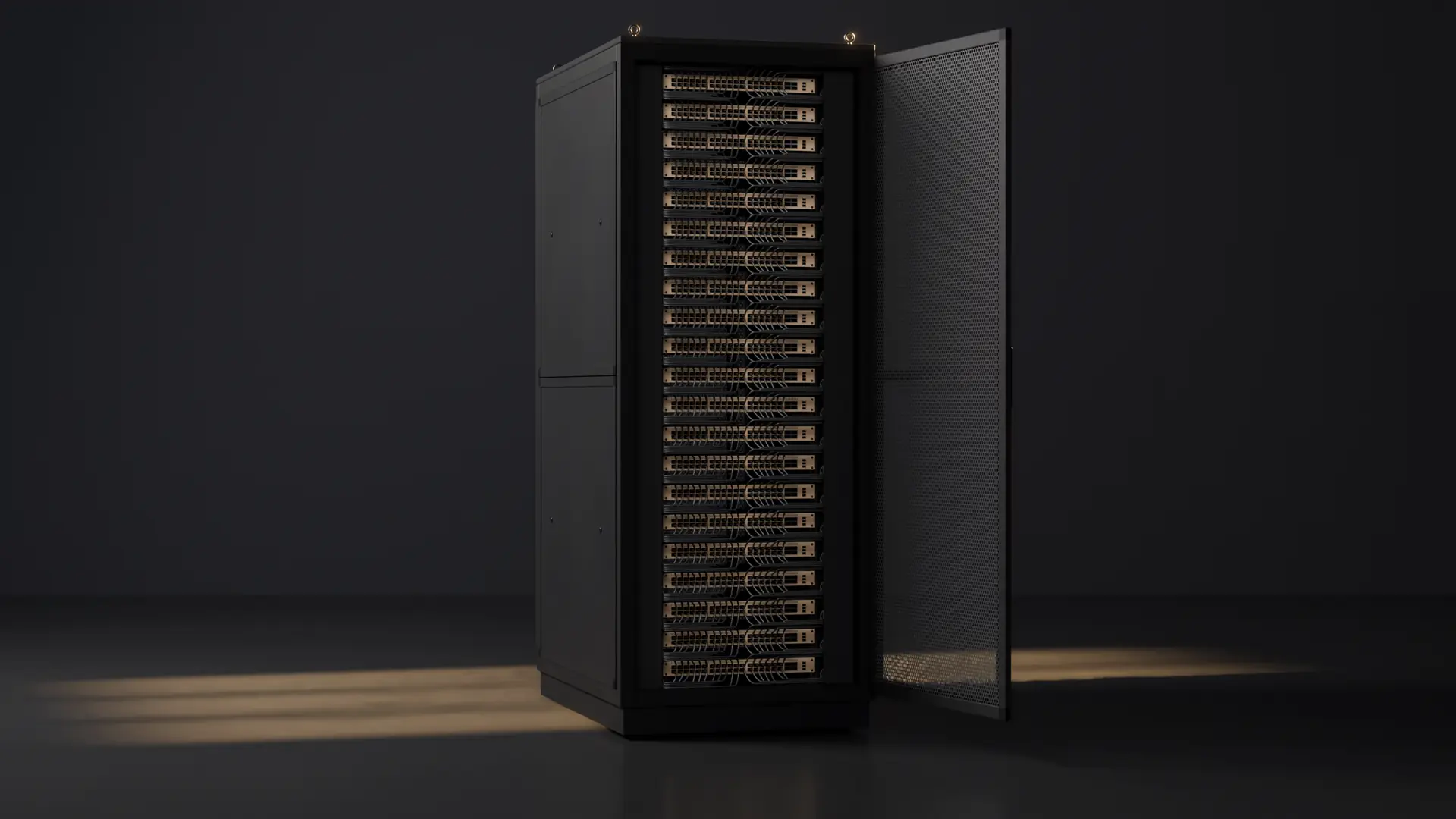

Then it boots.
